Knowledge middle builders are working right into a extreme energy bottleneck as they rush to construct greater amenities to capitalize on generative AI’s potential. Usually, they might energy these facilities by connecting to the grid or constructing a power plant onsite. Nonetheless, they face main delays in both securing gas turbines or in acquiring vitality from the grid.
On the Knowledge Middle World Energy present in San Antonio in October, natural-gas energy supplier ProEnergy revealed an alternate – repurposed aviation engines. In response to Landon Tessmer, Vice President of Business Operations at ProEnergy, some data centers are utilizing his firm’s PE6000 fuel generators to offer the ability wanted throughout the knowledge middle’s development and through its first few years of operation. When grid energy is offered, these machines both revert to a backup position, complement the grid, or are offered to the native utility.
“We now have offered 21 fuel generators for 2 data-center tasks amounting to greater than 1 gigawatt (GW),” says Tessmer. “Each tasks are anticipated to offer bridging energy for 5 to seven years, which is once they anticipate to have grid interconnection and not want everlasting behind-the-meter technology.”
Bridging Energy Gaps With a New Sort of Aeroderivative Turbine
It’s a widespread and long-established observe for gas-turbine authentic gear producers (OEMs) like GE Vernova and Siemens Energy to transform a profitable plane engine for stationary electric-power technology purposes. Often called aeroderivative fuel generators, these machines have carved out a distinct segment for themselves as a consequence of being lighter, smaller, and extra simply maintained than conventional heavy-frame fuel generators.
“It takes loads to industrialize an aviation engine and make it generate energy,” says Mark Axford, President of Axford Turbine Consultants, a gas-turbine advisor and a valuation skilled for used generators.
For instance, GE Vernova’s LM6000 gas turbine was derived from GE’s profitable CF6-80C2 turbofan engine which was extensively used on business jets. The CF6-80C2 was first launched in 1985, and the LM6000 appeared available on the market 5 years later. To make it appropriate for power generation, it wanted an expanded turbine part to transform engine thrust into shaft energy, a collection of struts and helps to mount it on a concrete deck or metal body, and new controls. Additional modifications usually embrace the event of gas nozzles that allow the machine run on natural gas slightly than aviation fuel, and a combustor that minimizes the emission of nitrogen oxides, a serious pollutant.
“There simply aren’t sufficient fuel generators to go round and the issue might be going to worsen,” says Paul Browning, CEO of Generative Power Solutions, previously the top of GE Energy & Water (now GE Vernova) and Mitsubishi Power. Contact GE Vernova to order an LM6000 at this time (or a Siemens Energy SGT-A35 aeroderivative gas turbine) and also you could be informed the ready checklist is wherever from three to 5 years. Some giant, in style, fashions have even longer ready lists.

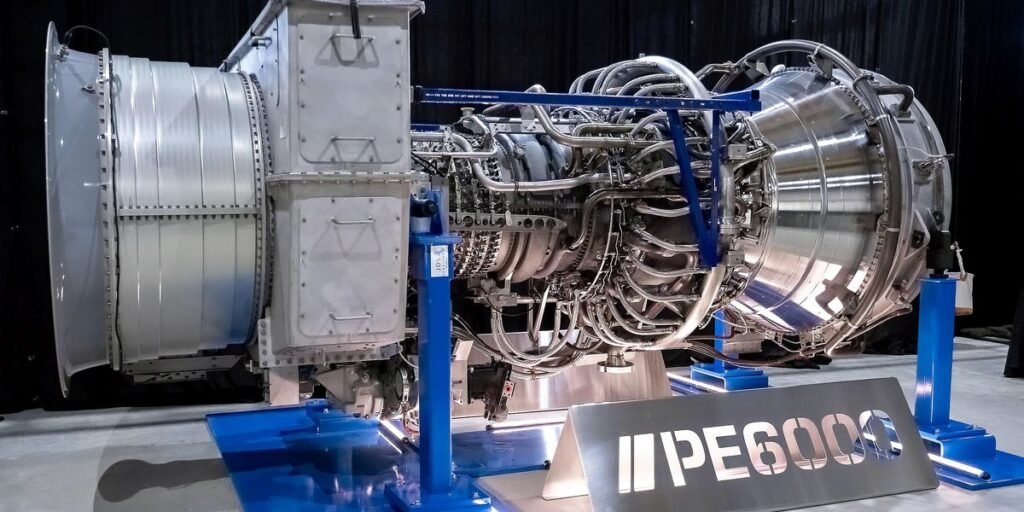

For distinction, “a PE6000 from ProEnergy will be delivered in 2027,” Tessmer says.
Vice chairman Landon Tessmer of ProEnergy spoke on the Knowledge Middle World Energy convention in October, 2025.Knowledge Middle World Energy
Transformed Turbofan Plane Engine Can Present 48 Megawatts
ProEnergy buys and overhauls used CF6-80C2 engine cores – the central a part of the engine the place combustion happens – and matches them with newly manufactured aero-derivative elements made both by ProEnergy or its companions. After meeting and testing, these refurbished engines are prepared for a second life in electric-power technology, the place they supply 48 megawatts (MW), sufficient to energy a small-to-medium knowledge middle (or a city of maybe 20,000 to 40,000 households). In response to Tessmer, roughly 1,000 of those plane engines are anticipated to be retired over the subsequent decade, so there’s no scarcity of them. A big knowledge middle could have demand that exceeds 100 MW, and a few of the newest knowledge facilities being designed for AI are greater than 1 GW.
An overhaul returns an engine and its parts to as-new situation. Every of its hundreds of elements are disassembled, cleaned, inspected, after which repaired or changed as wanted. On this manner, the engine is renewed for one more lengthy cycle of runtime. Other than the engine core, each half contained in the PE6000 turbine is manufactured to ProEnergy’s specs. “We will overhaul the high-pressure core of any CF6-80C2 and fabricate all of the low-pressure parts,” Tessmer provides.
ProEnergy sells two-turbine blocks with the usual configuration. It consists of fuel generators, mills, and a bunch of different gear, equivalent to techniques to chill the air getting into the turbine throughout sizzling days as a technique to increase efficiency, selective catalytic discount techniques to scale back emissions, and numerous electrical techniques. The corporate focuses solely on one engine, the CF6-80C2, to streamline and simplify engineering and upkeep.
The PE6000 was initially supposed to be used by utilities that wanted extra capability throughout peak hours. The data-center boom has turned that expectation on its head—data-center operators need these engines to offer energy to the complete facility. They run on pure fuel and, when being began, will be up and working in 5 minutes. If one wants upkeep, it may be swapped out with a spare inside 72 hours. Emissions ranges common 2.5 elements per million for nitrogen oxide, which is effectively beneath EPA-regulated levels (typically beneath 10 to beneath 25 elements per million, relying on the use case). Since 2020, ProEnergy has fabricated 75 PE6000 packages and now has one other 52 being assembled or on order.
Prolonged Grid-Connection Delays Imply Extra Enterprise
A number of elements contribute to this reputation. Moreover the surge in knowledge facilities, there’s typically a lengthy wait for transmission lines, which can face native opposition and require permits from a number of municipalities or states. “Aeroderivative fuel generators are gaining floor as a bridging know-how that runs behind the meter till the utility is ready to provide grid energy,” says Tessmer.
Tessmer has seen examples of eight-to-ten-year delays on allowing alone. If connecting to the grid continues to take years, no less than in some areas, and if fuel turbine producers don’t dramatically increase output, bridging energy may turn out to be an indispensable enabler of the buildout of AI infrastructure.
